North Coast Transmission Line construction activities

BC Hydro truck parked near a large power transmission tower in a rural landscape.

What's new

Copper Forest Service Road maintenance activities

Traffic disruptions are expected along the Copper Forest Service Road, North Copper Road, and Copper-Limonite Forest Service Road east of Terrace as our contractors complete road maintenance and bridge repair activities. The work begins on Tuesday, November 3, 2026, and is expected to continue through Tuesday, December 15, 2026, subject to weather and field conditions. Refer to the traffic advisory [PDF, 389 KB] to learn more.

Construction updates

Construction on Phase 1 of the North Coast Transmission Line (NCTL) project is underway. Learn more about the construction activities [PDF, 296 KB] taking place between October and December 2026.

Activities through November include:

  • Continued access road construction and upgrades, bridge replacement work, and transmission line relocation activities in Segment A1 between Prince George and Beaverly. Work may result in temporary traffic delays, single-lane alternating traffic, and brief road closures in select areas.
  • Timber clearing, aggregate development, right-of-way preparation, road upgrades, and new access road construction activities in Segments D, E, and F between Culculz Creek, Sinkut River, Stony Creek, and the Nechako River. Residents and road users may notice increased logging truck traffic, heavy equipment movement, and construction activity.
  • Continued tree clearing and site preparation activities at project facilities, including work at the Williston Substation expansion site near Prince George.
  • Ongoing development of workforce accommodation and project support facilities, including construction of the Vanderhoof worker accommodation site and laydown yard, transportation and installation of dormitory units, development of the Prince George laydown yard, and construction office renovations.
  • Geotechnical investigations, including drilling and test-pitting activities, continue at select locations to support future construction planning and design.

Construction activities

We've divided the transmission line corridor into segments (shown in the figure below). Construction bulletins will tell you which segment we're working in—or planning to work in—and outline the specific activities and potential impacts in that area.

Constructing a transmission line involves several key steps. Here's an overview of the work you can expect.

Construction preparation

This early stage includes work to get the site ready:

  • Clearing areas for station expansion, the transmission line right-of-way, and access roads
  • Upgrading and building roads
  • Re-aligning existing transmission lines as needed

Transmission line construction

Once the area is prepared, we move into building the line:

  • Installing tower foundations
  • Erecting the towers
  • Stringing the transmission wire

Substation and capacitor bank expansion

Depending on site, activities may include:

  • Clearing land for expansion
  • Installing fencing
  • Developing foundations, pads, and other supporting infrastructure
  • Delivering and installing equipment

Ancillary facilities

To support construction activities, we also develop:

  • Workforce accommodation
  • Laydown and storage areas
  • Heli-pads (required for Phase 2 only)

Reclamation

After construction in an area is complete, we'll restore disturbed sites as part of our reclamation work.

In 2026, Phase 1 construction activities will focus on the following areas:

  • Clearing and developing access routes in Segments D, E, and F
  • Re-aligning the transmission line between Williston Substation and Beaverly Substation in Segment A1
  • Building workforce accommodation in Vanderhoof, near Segment E
  • Establishing a laydown and storage area in Prince George

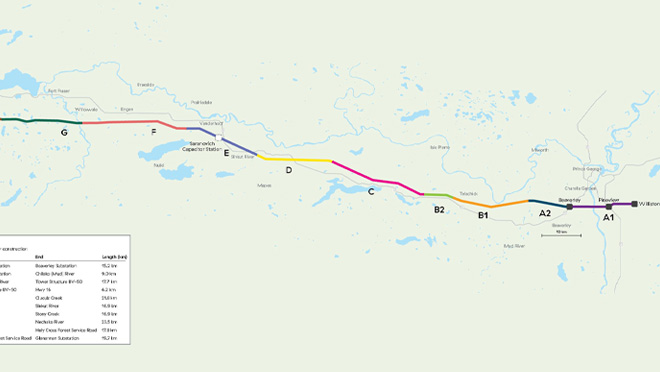

North Coast Transmission Line Phase 1: Construction Segments

North Coast Transmission Line Phase 1: Construction Segments

View the project map [JPG, 177 KB] at a larger size.

In 2026, Phase 2 construction activities will focus on early works such as road maintenance and brushing to maintain key roads. This work will happen across all line segments.

North Coast Transmission Line Phase 2: Construction Segments 5LO65

North Coast Transmission Line Phase 2: Construction Segments 5LO65

View the project map [JPG, 279 KB] at a larger size.

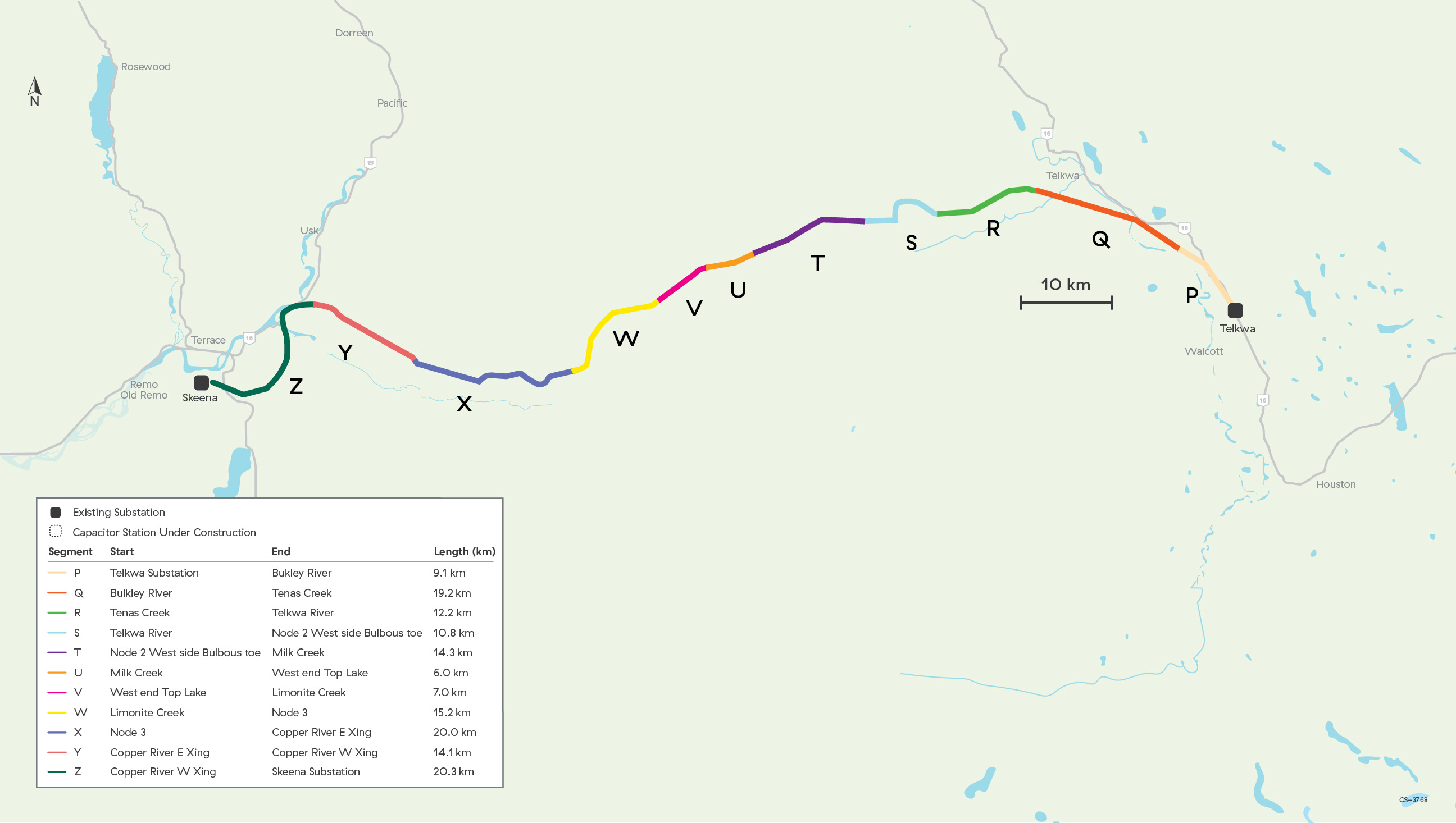

North Coast Transmission Line Phase 2: Construction Segments 5LO66

North Coast Transmission Line Phase 2: Construction Segments 5LO66

View the project map [JPG, 227 KB] at a larger size.
